20ft Expandable Prefab Home Australia — NCC Compliance, Granny Flat Rules

Publish Time:

20ft Expandable Prefab Home Australia — NCC Compliance, Granny Flat Rules

A Custom 20ft Expandable Home Built for Australian Living

Australia's average home price surpassed AUD $922,838 in early 2026 — with Sydney's median reaching AUD $1,292,157. Traditional construction costs run AUD $2,500–$3,500 per square metre, and build timelines stretch 12–18 months even for modest additions.

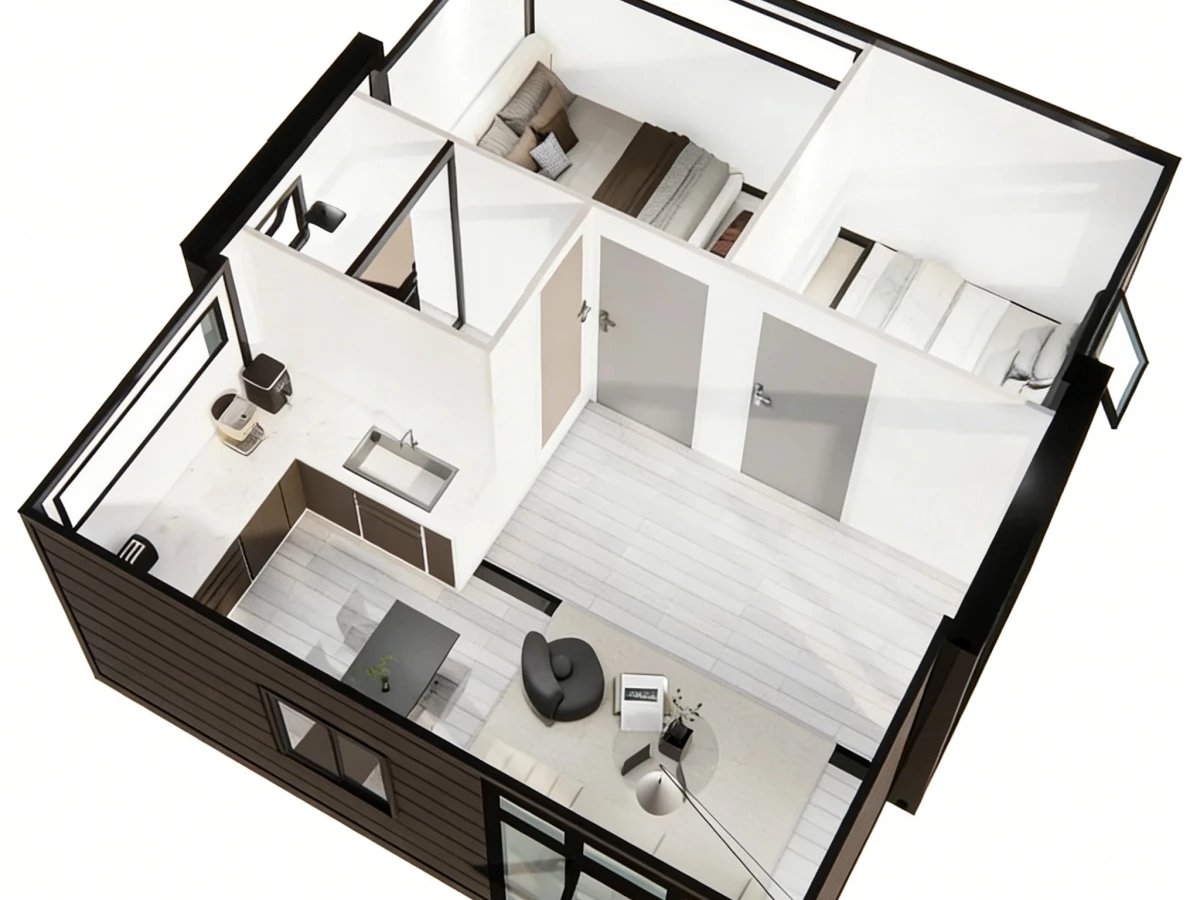

An Australian homeowner approached UVO with a clear brief: a fully functional, long-term residence built to their specifications, adapted to the Australian climate and lifestyle — without the cost or timeline of a traditional build. The result is a custom-configured 20ft UVO expandable container home, now permanently installed and occupied.



What Was Customised: Four Upgrades on the Standard Layout

1. Exterior: Metal Embossed Panel Facade

The standard exterior panels were replaced with metal embossed panels:

  • UV resistance: Rated for Australia's extreme UV exposure — no fading, peeling, or degradation
  • Weather resistance: Protects against coastal salt air, tropical cyclone rainfall (QLD), and dry inland wind (WA/SA)
  • Visual appeal: Embossed surface adds architectural depth and a premium appearance

2. Structural: Custom Pitched Roof

  • Enhanced drainage: Moves water off the structure faster; reduces pooling risk at expansion joints during intense Australian summer rainfall
  • Insulation improvement: Roof cavity adds thermal buffer — critical for reducing heat gain in climate zones 1–4
  • Solar management: Pitch and overhang adjusted to block summer sun while allowing winter sun penetration

3. Functional: Outdoor Balcony

  • Extends usable space without increasing enclosed footprint (important for granny flat size calculations)
  • Reflects Australian preference for outdoor entertaining and cross-ventilation
  • Creates indoor-outdoor transition suited to the Australian lifestyle

4. Bathroom: Full Upgrade Package

  • High-quality fixtures throughout
  • Full wet/dry separation — shower cubicle isolated from toilet and vanity
  • Smart fixtures: sensor tap, heated towel rail, LED mirror
  • Instant hot water system pre-installed
  • Waterproofing applied to all wet areas per AS 3740 requirements

20ft Expandable Prefab Home Australia — NCC Compliance, Granny Flat Rules

Project Specifications

Parameter Detail
Usable area (expanded) Approx. 37 m² (398 sq ft)
Configuration Living / bedroom / kitchen zone / full bathroom
Exterior wall Metal embossed panel, UV-rated
Roof Custom pitched with thermal cavity
Windows/doors Double-glazed tempered glass, thermal break aluminium frames
Insulation 75mm polyurethane foam sandwich panel
Certifications SAA, WA (electrical), CE, ISO



NCC Compliance: The Most Important Section for Australian Buyers

The question every serious Australian buyer asks — and most suppliers avoid answering directly:

Here is a direct answer.

What NCC Class 1a Requires

If the home is used as a permanent or semi-permanent residence connected to water, sewer, and electricity, it is assessed as a Class 1a dwelling under the NCC — the same classification as any house or granny flat. There is no exemption for prefabricated or expandable structures.

The NCC does not prohibit expandable homes. Class 1a approvals already exist in NSW, VIC, and QLD. What the NCC requires is that the home performs to the same standard as a site-built dwelling — and that documentation proves it. Here is how the UVO 20ft unit addresses each key requirement:

Structural Performance (NCC Section B)

  • Hot-dip galvanised welded steel frame — tested across Australian wind classifications N1 through N4 and cyclonic C regions
  • Tie-down and anchor point specifications provided for certified footing design
  • Structural calculation report included — ready for submission to your private certifier or council

Energy Efficiency: 7-Star NatHERS

From May 2024, all new Class 1a dwellings require a minimum 7-star NatHERS rating.

The UVO 20ft unit addresses this through:

  • 50mm polyurethane foam wall and floor panels (R-2.5 to R-3.0 thermal performance base)
  • Custom pitched roof with cavity — adds insulation above the ceiling plane
  • Double-glazed Low-E glass — reduces solar heat gain in summer, heat loss in winter
  • Thermally broken aluminium frames — eliminates cold bridging at window perimeters

A NatHERS certificate is issued by your local accredited assessor using site-specific data. UVO provides the full building specification data required for the assessment. Achieving 7 stars is feasible with this unit, properly oriented.

Fire Safety and BAL Compliance

The non-combustible steel frame and metal cladding satisfy the core BAL structural requirement:

  • BAL 12.5 to BAL 29: Satisfiable with appropriate detailing on this unit
  • BAL 40 / Flame Zone: Additional engineering specifications required — specify your BAL rating at the design stage

Waterproofing: The Critical Expansion Joint

The fold-out expansion joint is the most common reason expandable homes fail NCC assessment. UVO's system uses:

  • Continuous EPDM rubber gasket seal at the roof-level junction
  • Stepped flashing detail at the wall junction
  • Floor-level membrane treatment at the expansion threshold
  • The custom pitched roof further reduces water exposure at the joint by directing rainfall away from the junction zone

Plumbing: WaterMark Compatibility

Australian plumbing law requires all tapware and fittings connected to mains water supply to carry WaterMark certification. CE or other international marks are not substitutes.

UVO's approach: The unit ships with plumbing rough-in completed (pipes pre-routed, connection points positioned). Tapware and final connections are installed on-site by your local licensed plumber using WaterMark-certified fittings — the only legally correct approach.

Electrical: SAA/RCM Certified

All electrical components carry SAA/RCM (Regulatory Compliance Mark) certification. The pre-wired system is connected to mains supply by your local licensed electrician.



Cost Comparison: UVO vs. Traditional Australian Construction

Method Typical Cost Timeline
Traditional Australian site build AUD $2,500–$3,500/m² (~$92,000–$130,000 for 37 m²) 12–18 months
Local modular/prefab builder AUD $150,000–$250,000 total 6–12 months
UVO expandable unit(factory-direct) Significantly below local modular pricing — contact for quote 50–65 days factory to site

The saving versus traditional construction is structural — not a marketing estimate. Factory production eliminates Australian on-site trade rates (AUD $50–$100/hour), the primary cost driver in domestic construction.



Factory to Your Australian Property: Delivery Timeline

Weeks 1–4: Factory production Built to specification — roof type, exterior panel, bathroom grade, balcony configuration confirmed in week one. Full QC inspection before folding for shipment.

Weeks 4–7: Ocean freight Shipped to your nearest Australian port:

  • Port Botany (Sydney) — NSW, ACT, southern QLD
  • Port of Melbourne — VIC, TAS, SA
  • Port of Brisbane — QLD
  • Fremantle — WA

Transit time: approximately 18–25 days.

Week 7–8: Customs clearance and inland delivery Australian customs cleared by your freight forwarder. Flatbed truck to site — most metropolitan locations within 1–2 days of port clearance.

Days 1–2 on-site: Installation Unit positioned on certified footing, wings unfolded, locked, levelled, and sealed. Electrician and plumber complete utility connections: 1–2 additional days.



Frequently Asked Questions

Does a UVO expandable home meet NCC requirements for Class 1a approval in Australia?

The unit is engineered to NCC performance standards and includes a documentation package — structural report, electrical certification, thermal performance data, waterproofing spec — to support Class 1a approval applications. Compliance is confirmed by your local certifier or council.

Can I use this as a granny flat in NSW, VIC, or QLD?

Yes. At 37 m², it falls within the granny flat size limit in all three states. In NSW it qualifies for CDC (approximately 20 business days). In VIC, a building permit alone is typically sufficient under the 2024 reform — no planning permit needed in most residential zones.

Is the plumbing WaterMark certified?

The unit ships with pre-routed plumbing rough-in. Tapware and final connections are installed on-site by your local licensed plumber using WaterMark-certified products — the legally required approach under Australian plumbing law.

How long does delivery from China to Australia take?

Ocean freight to major Australian ports takes approximately 18–25 days. Total factory-to-site: 50–65 days from order confirmation.

Can it be installed in a bushfire-prone area?

The non-combustible steel frame and metal cladding satisfy BAL 12.5 to BAL 29 with appropriate detailing. For BAL 40 or Flame Zone properties, specify your BAL rating at the design stage for upgraded engineering.
